← All room addition case studies
Case study

Room addition foundation in Wheaton

A great room on the back of a brick colonial, dug the week of Thanksgiving and poured in December with snow on the ground. Cold weather does not stop a foundation. It changes how you pour one.

The buildOne story great room, vaulted ceilings
TownWheaton
On siteAbout 25 days, Nov to Dec 2025
BuilderDe Groot Construction

The job

De Groot Construction is one of Abel's top builders. The addition is a one story great room with vaulted ceilings, so the walls sit tall, off the back and side of a brick colonial beside the sunroom. There was an old brick paver patio where it goes. Abel demoed it, hauled it out, and then poured a full footing and foundation wall for the great room.

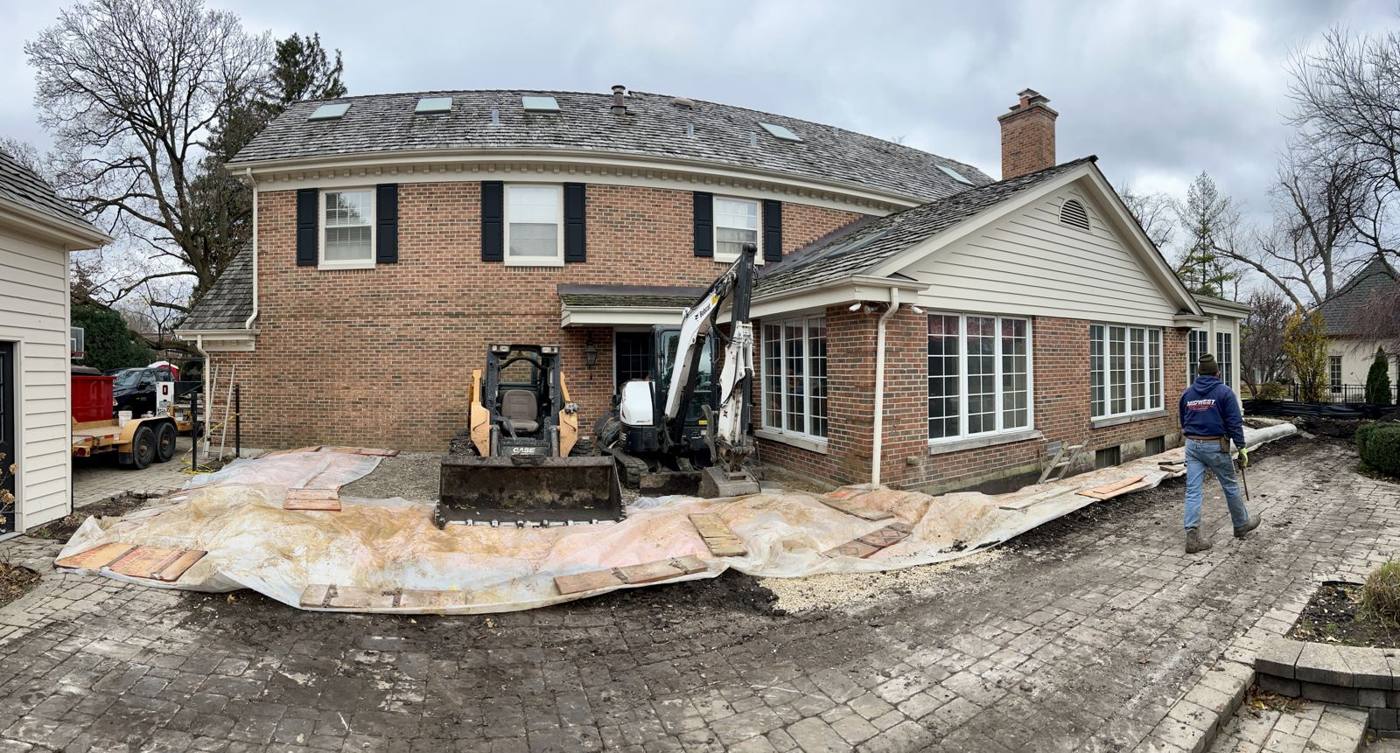

Back of a brick colonial in Wheaton with plastic and boards over the paver patio and a skid steer and mini excavator arrivingBefore · Nov 26
Day one. Plastic and boards down over the pavers before any equipment rolled across them.

What made it hard

Two things. The first was the calendar. The dig started the week of Thanksgiving, and by the time the footings were ready on December 8th there was snow on the ground. Concrete that freezes before it cures loses strength, and nobody finds out until something cracks.

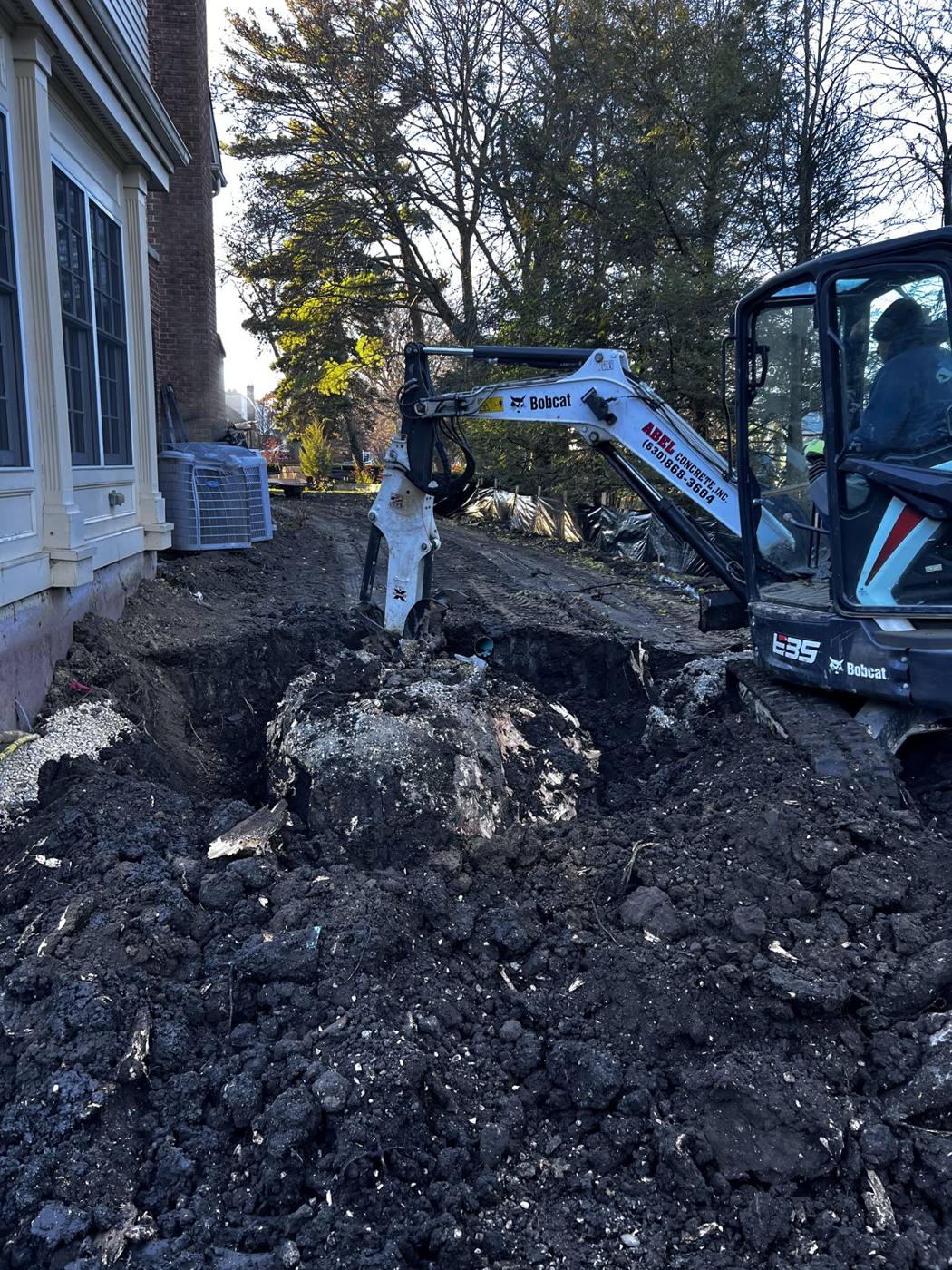

Mini excavator digging beside the house
Nov 28. The dig, tight to the house.

Insulated blankets laid in the footing trench with snow on both sides
Dec 8. Snow on the ground, blankets in the trench.

The second was the layout. The addition is big and it wraps in different spots across the back and side of the house. That made it hard to get the tractor and the other equipment to every part of it. So the walls went in by pump truck, with the boom reaching over the house from the street.

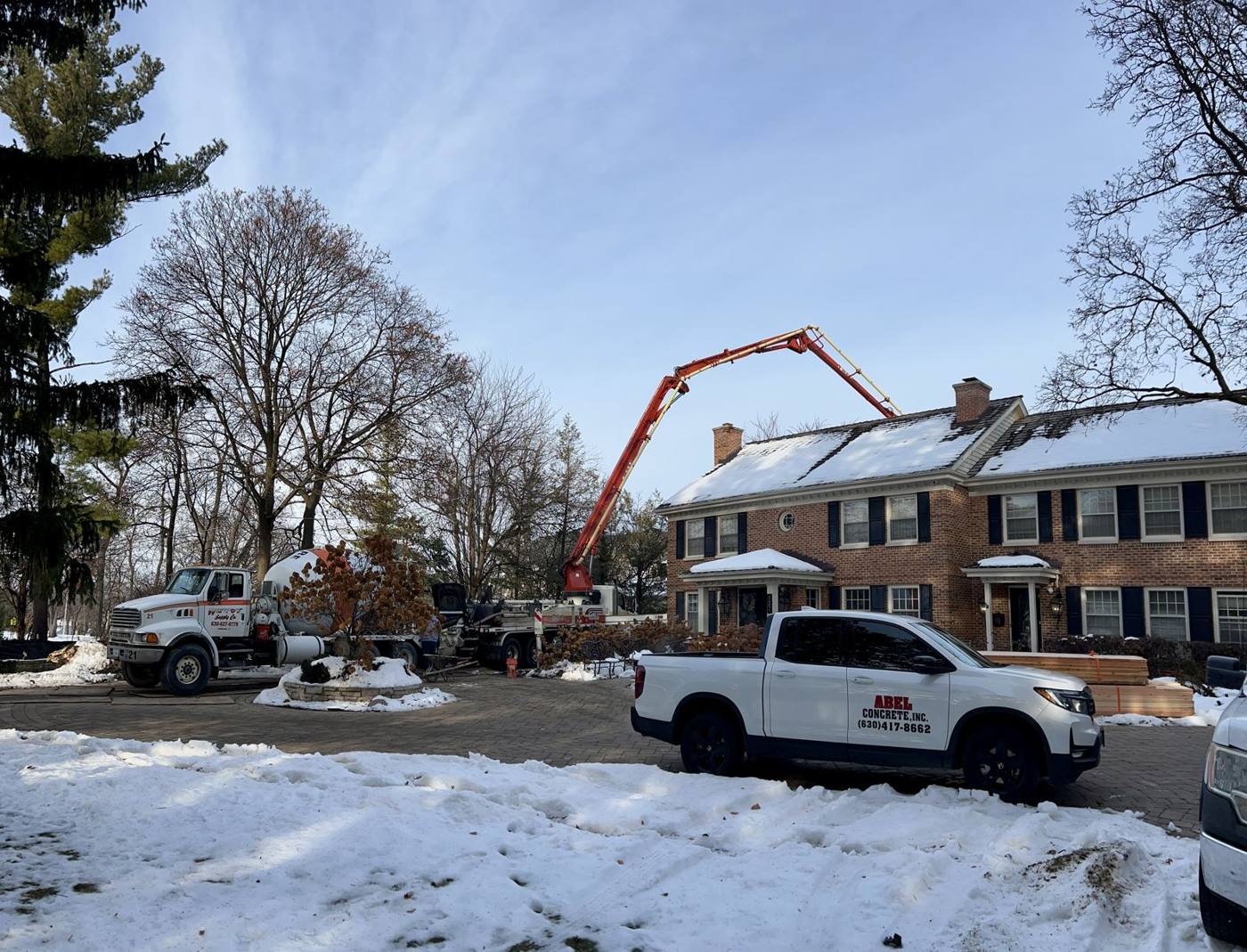

Concrete pump truck parked in the street in front of the house
Dec 17. Pump truck in the street. The boom went over the house.

Wall forms full of concrete with the pump boom overhead
Dec 17. Walls poured in one morning.

How we did it

The old patio came out first. Plastic and boards went down over the pavers that stayed, so the equipment never touched them.

Once the footings were poured, insulated blankets went over them and into the trenches to keep the ground from freezing. The blankets went back over the concrete after every pour. Cold or not, the concrete had to cure right.

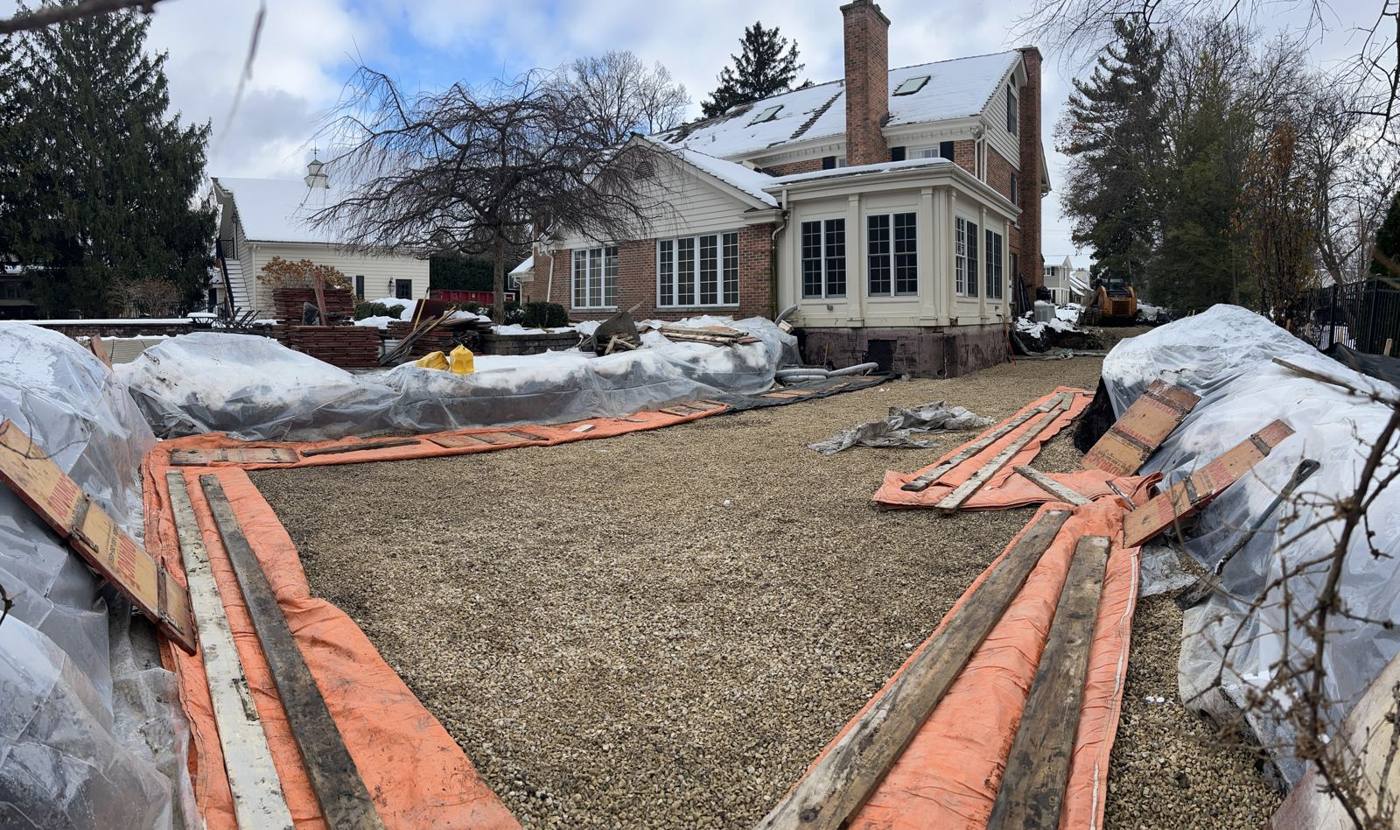

Footings covered in blankets with a leveled gravel base inside
Dec 10. Footings in and covered, gravel base leveled.

The gravel base was spread and leveled inside the footings. The walls went in by pump on December 17th, and they got damp proofing before the backfill.

What the builder got

Finished foundation walls beside the sunroom, damp proofed, with orange insulated blankets over the insideAfter · Dec 28
Walls poured, damp proofed, and blanketed against the cold.

The walls were in, damp proofed and wrapped by December 28th, about 25 days on site. Nothing came back. No callback, no crack, no fix. The builder and the homeowner were both happy, and Abel is back on the lot now for the concrete stoops and the patios out back.

Every job, not just these three

The parts that do not change.

Three different lots, three different towns, three different sets of problems. These are the things that were the same on all of them.

1

One crew digs it and pours it

The excavating and the concrete are the same company and the same men. No separate excavator to schedule, no gap between the two, and nobody to blame if the hole is wrong.

2

Six bag mix, every pour

There is a cheaper way to order concrete and Abel does not order it. Same mix on a garage floor as on a foundation wall.

3

The neighbors get handled first

Abel is usually the first trade on the lot and the one on the property line at six in the morning. John has that conversation before the equipment shows up, so it stays off the builder's plate.
